Home NewsTypical Steel Structure Scope in a Petrochemical EPC Project

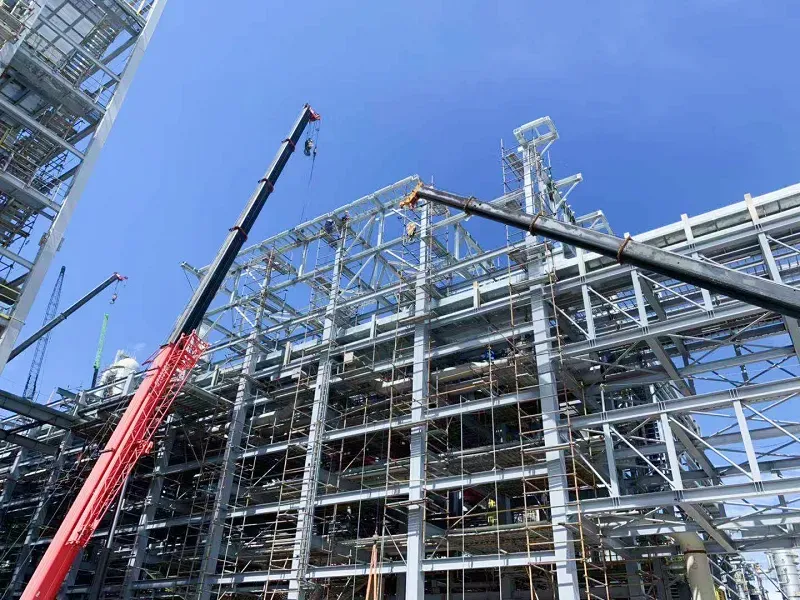

Typical Steel Structure Scope in a Petrochemical EPC Project

Time:2026-02-06 07:10:03 Source:Sanjian Meichen Steel Structure

Scope gaps drain cash and time. Unclear steel limits spark claims. We share a practical steel scope for petrochemical EPC, with tables and field notes, so schedules and budgets hold.

In petrochemical EPC, steel scope covers primary frames, secondary access steel, buildings, utility and E&I steel, embedded interfaces, fireproofing and coatings, erection aids, and full documentation. We also define exclusions and battery limits with civil, piping, mechanical, and construction to avoid overlap and rework.

If you lead procurement or engineering, this is your quick map. We mix checklists with stories. We keep it simple and specific. Keep reading; the next sections solve real site problems you likely face.


What does steel scope include in petrochemical EPC?

Confusion over inclusions causes delays. Loose lists invite claims. We fix that with a clear map and consistent naming across drawings, MTOs, and ITPs.

Steel scope includes primary frames, secondary access steel, buildings and shelters, utility and E&I steel, embedded interfaces, fireproofing/coatings, erection aids, and documentation. We align this scope with civil, piping, and mechanical so each item has a single owner and a clear handoff.

Dive deeper: We start by locking a category map. We attach it to the steel package and the interface matrix. It stops double ownership and the “I thought you had it” debate. We give each category a short code that follows the model and the drawings. We tie lifting points and PFP zones to the same codes. When we miss something, it shows up fast in the MTO and in the QA packs.

Category Typical inclusions
Primary frames Pipe racks and bridges, equipment supports, reactor/column platforms, flare towers, loading racks, air-cooler racks
Secondary steel Platforms, stairs, ladders/cages, handrails, toe plates, gratings, walkways, monorails, runway beams, davits
Buildings and shelters Steel frames for substations, MCCs, analyzers, steel control buildings, workshops, warehouses, open shelters
Utility and E&I steel Cable tray bridges, frames for firewater/utility headers, instrument shelter supports, lighting masts, towers
Embedded interfaces Baseplates, anchor bolt templates, grout pockets, coordinated embeds in concrete
Fireproofing and coatings PFP on designated members; paint, HDG, or duplex per environment
Erection aids Temporary bracing, lifting lugs/eyes, sea-fastening for modules
Documentation and turnover Design calcs, models/drawings, MTOs, weight reports, QA/QC dossiers, methods, as-builts

On a large rack job, we used this table as Annex A. The handrail and monorail scope stayed clean. No late claims.

Where do battery limits sit, and what is excluded?

Missing limits block site work. Mixed ownership creates scope gaps. We publish limits in week one and we walk the model with each lead.

Battery limits usually exclude civil works, tanks, scaffolding, insulation, cranes, and pipe line supports. Structural supplies frames to attach piping and equipment, while piping owns shoes, guides, and springs. We confirm secondary steel ownership at large pipe supports early.

Dive deeper: We write limits in plain language and place them on drawings. We tag locations with small triangles and codes. We freeze these with an interface matrix. We then brief construction so field teams know what the steel package does not include. This single step saves time in the yard and keeps purchase scopes tight. We add notes for corrosion category boundaries and for PFP terminations. We include anchor projection rules that account for grout and PFP thickness. Bad templates kill schedules, so we use steel templates and sometimes 3D-printed jigs for complex clusters.

Item/Discipline Owner Notes
Foundations, piles, sleepers Civil Structural issues baseplate set-out and templates; civil places anchors and pours grout
Anchor bolt placement Civil Projection includes grout and PFP; structural provides templates and survey data
Pressure equipment Mechanical Structural provides frames and seats; mechanical owns equipment, nozzles, hold-down hardware
Pipe supports on lines Piping Shoes, guides, and springs by piping; structural provides frames and clips
Tanks and spheres Mechanical Shells/roofs by mechanical; stair towers and ring platforms often mechanical; confirm early
Scaffolding and insulation Construction Excluded unless defined as temporary steel in structural scope
EOT cranes Others/Building Crane equipment by others; runway beams and supports may be structural
Coatings/PFP limits Structural Freeze faying surface class and fire zones; define terminations at concrete and interfaces

We locked jetty impact loads and cathodic interfaces in week two. The marine coating scope stayed simple. Punch lists were short.

How should we set engineering and design?

Weak criteria force redesign. Missing loads break connections. We set the basis early and we use standard families for members and joints.

Define wind, seismic, blast, thermal, settlement, and accidental loads. Align codes and owner standards. Deliver a clean 3D model, GAs, connection details, erection drawings, bolt lists, MTOs, weight reports, and a stability plan for erection.

Dive deeper: We start with a one-page design basis summary. We list loads, temperatures, fire zones, and coating category. We then pick the code set and PIP standards. We model in SP3D, PDMS, or Tekla and lock bay grids and expansion joints. We keep connections from a catalog. We set hole classes by joint type. We run blast and fire studies early. We add anchor design to seismic checks. We keep dynamic rules for rotating equipment and tuned monorails. We specify Z-quality plate for thick restrained baseplates. We add camber rules for long beams and bolt-down clips for gratings. We produce lifting studies and an erection stability plan. These keep field work safe and sequenced.

Topic Decision
Loads Wind, seismic, blast, thermal, settlement, accidental
Tmin and toughness CVN at Tmin for critical members
Structural codes AISC/ASCE, EN 1993/1991, or GB 50017/50011
Fire and siting UL 1709/ISO 22899 PFP; API RP 752/753 siting; PIP standards
Coatings standards ISO 12944, NORSOK M-501, AMPP
Deliverables 3D model, GAs, connections, erection drawings, bolt lists, MTOs, weights, lifting/stability

We reserved capacity in key rack bays. Late piping loads came in. We did not redraw connections.

Which procurement choices avoid rework?

Wrong steel or bolts cause rework. Bad coatings cost years in maintenance. We lock choices early and we test them with vendors.

Use steel grades with impact toughness where needed. Select bolts that work with galvanizing and slip-critical joints. Pick coatings and PFP by environment and fire study. Prequalify mills, galvanizers, coating shops, and fabricators for capacity and QA.

Dive deeper: We make a short procurement spec set. We list grades, CVN requirements, bolt grades, nut and washer specs, and lubrication rules. We set faying surface class where slip-critical joints exist. We choose paint, HDG, or duplex by area and life. We pick epoxy intumescent for hydrocarbon and jet fire zones. Cementitious is only where the owner allows and risk is low. We check galvanizers’ bath length. It drives splice locations and shipping limits. We check coating shops for C5M and UL 1709 capacity. We check fabricators’ WPS/PQR and NDT equipment. We plan transport envelopes and sea-fastening. We test lift at the shop for large modules.

Item Preferred options and notes
Steel grades A36/A572 Gr50, S275/S355, or Q345; Charpy at design Tmin on critical members
Bolts F3125 A325 or ISO 8.8; avoid HDG on A490/10.9 due to hydrogen embrittlement
Nuts/Washers A563 nuts, F436 washers; DTI washers if required; matched and pre-lubed assemblies
Faying surfaces Class B for slip-critical joints; protect during storage
Coatings C4: 3-coat paint; C5M: duplex for small repetitive items; marine zones: add cathodic notes
PFP Epoxy intumescent per UL 1709; define thickness, mesh, edge seals, topcoat

We locked Class B faying surfaces at FEL-3. No late re-blast. No schedule slip.

What fabrication controls protect fit-up and coating?

Poor fit-up kills time. Bad DFT and cure logs block handover. We set WPS, NDT, and dimensional checks. We run trial assemblies for complex pieces.

Qualify WPS/PQR and welders. Plan NDT by criticality. Control dimensions and match marks. Prepare surfaces right. Apply coatings and PFP with strict DFT, cure logs, and edge detailing. Add inspection plugs for PFP.

Dive deeper: We build an ITP with clear hold and witness points. We add weld maps and sampling matrices. We control heat input and distortion. We avoid flame straightening on HDG items unless we qualify a procedure. We run trial fits on stairs, platforms, and modules. We match-mark across nodes and member ends. We blast to Sa 2.5 and record profile. We keep Class B faying surfaces clean and protected. We drill vent and drain holes for HDG and seal after galvanizing. We control DFT with calibrated gauges. We do holiday testing and record cure logs. We radius edges and stripe coat welds and cut edges. We detail PFP terminations, nozzle penetrations, and inspection plugs for future checks. We use QR tags to link each piece to drawings and QA records.

Joint type NDT/control
Full-pen splices UT/RT per ITP; monitor heat input; manage distortion
Fillet and attachments MT/PT by sampling; mark and record
HDG items No flame straightening unless procedure qualified
Dimensional checks Trial assemblies; match-marking; survey reports
Coating/PFP DFT gauges, holiday tests, cure logs; edge radius; stripe coats; inspection plugs

We shipped platform “super-panels” with handrails and gratings preinstalled. Erection time dropped. Punch items fell by half.

How do we plan erection, interfaces, and turnover?

Weak sequence plans cause chaos. Missing QA blocks handover. We plan stability and QA from day one and we stick to it.

Build an erection sequence with temporary bracing and guying. Control bolting and grout. Coordinate fit-up with piping, equipment, and cable trays. Plan touch-up and PFP repairs. Turn over with full MDR and ITR packs linked to QR codes.

Dive deeper: We erect by bays and we add temporary bracing. We set survey hold points at each level. We define bolting method as turn-of-nut or calibrated wrench. We keep tension records by joint type. We protect Class B faying surfaces during erection. We level baseplates with shims or level-nut and use non-shrink grout. We add baseplate drains where needed. We define anchor tightening sequence and record torque or tension. We align with piping, equipment, and trays with survey control. We allow slotted holes and small adjusters where permitted. We run touch-up paint and PFP repairs with environmental control. We do final inspection and close punch items with clear NCR records. We turn over with MTCs, weld maps, NDT reports, coating DFT maps, PFP QC, bolt tension logs, as-builts, load test certificates, and earthing checks.

Topic Method and records
Sequence Erect by bays; temporary bracing; survey hold points
Bolting Turn-of-nut or calibrated wrench; tension logs
Baseplates/grout Shims or level-nut; non-shrink grout; drain details; anchor sequence
Interfaces Survey control; slotted holes; adjustable details
Repairs Controlled touch-up and PFP repair; cure records
Turnover packs MTCs, weld/NDT reports, DFT maps, PFP QC, bolt logs, as-builts, load tests, earthing

On a brownfield tie-in, laser-scan to Tekla kept fit-up clean. No site cuts. No weekend rush.

Where can we save time and cost without risk?

Random cuts hurt quality. Smart VE saves time and money. We push standardization, coatings strategy, PFP optimization, bolt plans, and modularization.

Use connection catalogs and section families. Choose duplex in C5M for long life. Optimize PFP with fire analysis. Use DTI for faster bolt acceptance. Shop-assemble “super-panels.” Split coating and PFP across shops to avoid bottlenecks.

Dive deeper: We start VE by fixing risk first. We run envelope loads so late vendor data does not break us. We book coating and PFP slots early and qualify alternates. We freeze model by zones and guard fabrication with clear change rules. We align plate and section availability to local mills. We avoid odd rolled sizes that create import risk. We use standardized connection families so we cut 20–30% of detailing and fab hours. We choose duplex systems for stairs and handrails in C5M so life-cycle cost wins. We analyze braced bays to reduce PFP where allowed. We add shields only when owner standards allow. We switch to A325 HDG for outdoor painted/galvanized joints. We use DTI to speed acceptance and reduce retorque disputes. We ship platform “super-panels” with kitted fasteners and QR codes.

Lever Impact
Standardized connections 20–30% fewer detailing/fab hours; fewer RFIs
Coating system choice Duplex wins life-cycle in C5M for 25-year life on stairs/handrails
PFP optimization Fire analysis reduces quantity; shields where allowed
Bolt strategy A325 HDG outdoors; DTI speeds acceptance and lowers disputes
Modularization Shop “super-panels”; PAR/PAU; test lifts; fewer work-at-height
Risk controls Envelope loads; split coating/PFP packages; zone model freeze; local section alignment

We froze the fire study at FEL-3 on a coastal unit. A jet fire change would have doubled PFP and added twelve weeks. That early lock saved the job.

Conclusion

Define scope and limits early. Lock basis, coatings, bolts, and PFP. Standardize and modularize. Document well. Do these simple steps, and your EPC steel stays on track.
